Setting up a WBS Descriptive (Parent/Child Code) Export
Cobra Import file - WBS Desc CSV
Steps
Description / Image

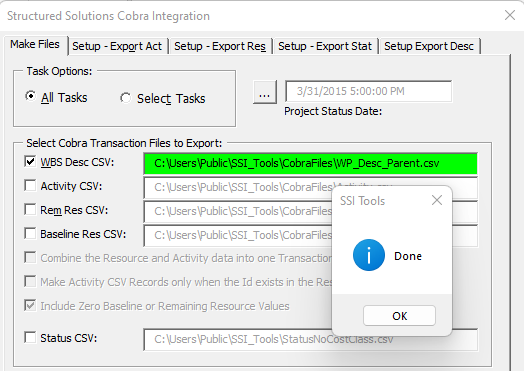

Make WBS Transaction File for use with Deltek Cobra™
· WBS Desc CSV is a Parent/Child hierarchical Code file for Cobra.
· A common use has Work Package as the “Child” item and Control Account as the “Parent” but you can use this for any hierarchical Code structure in Cobra.

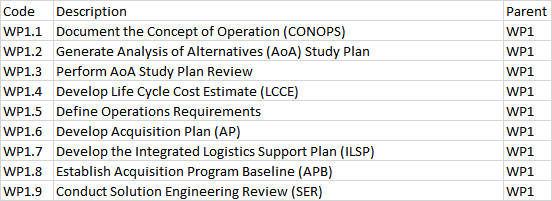

· The output format for this is the “Code”, “Description” and “Parent” for each Earned Value (EV) element.
o “Code” is the “Child” of the “Parent”
o “Description” is the name of the child element.
The Tab named Setup Export Desc controls which Microsoft Project text fields map to Code, Description and Parent
