Performance and Earned Value / EV Performance Reports

Released as 13.5.0
Change Number
13.5.EVM01a – Program level Reporting
Correction, Change or New feature
New Feature: EV Express by Program


Detailed Explanation
In the prior version, EV Express data was reported by Project Unique Name or ID and the Project Status Date.  This version adds an optional Program name to enable EV Express reporting for one or more project name in a common Program Name

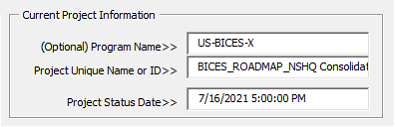

Option to make EV Express reports by a program name Program with the ability to filter or group by Projects withing that program.

Change Number
13.5.EVM01b – Program level ACWP Import and Reporting
Correction, Change or New feature
New Feature: Import ACWP by Program & Project

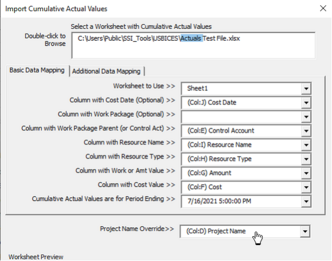

Added a Project Name Override field map to Import Cumulative Actual Values form to enable the import of ACWP by a Program name and a Project name in order to support Program level EV Express reporting.

Change Number
13.5.EVM01c – Replace ACWP for all projects in a period
Correction, Change or New feature
New Feature: Detection of ACWP records in same period



In prior versions, users had to delete ACWP records in the same reporting periods to avoid doubling of the cumulative ACWP values.

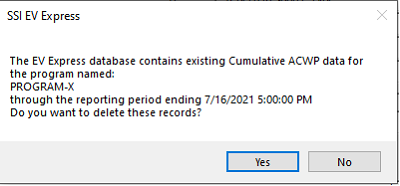

This version detects the existence of ACWP records for the active Program and Reporting Period.  If found, the user is given the option to delete the existing records ACWP associated with the Program name and the Reporting Period Ending date.

Build Release
13.5.0 09-21-2021


Change Number
13.5.EVM02 – Handle Cost Resource Type, Completion of 13.4.EVM04 – Handle Cost Resource Type
Correction, Change or New feature
Correction – Data type mismatch error using Cost resource type.


Detailed Explanation
In the prior version, a task with a Cost resource type would cause a Data type mismatch error if the user selected the option to Include Task Usage (Resource Assignments) since Assignment level work is null and the database is expecting a numeric value.  Nulls are now replaced with zero for Assignment Work, Cost, Actual Work & Cost, Baseline Work & Cost, Remaining Work & Cost.

A chance in Version 13.4.9 (13.4.EVM04) did not handle all conditions intended for this correction.  Handling of cost resources on completed tasks was not included in 13.4.9 and is now corrected with this version.

Build Release
13.5.0 09-21-2021
